AkiraConstruction
WhatsApp
Kovilpatti · Tamil Nadu

Civil engineered.
Honestly built.

Turnkey houses from G to G+2 in Kovilpatti and nearby towns. Design, estimate, construction and handover, all handled directly by one qualified civil engineer.

  • B.E. (Civil) engineer on every site
  • Free site visit
  • Written, itemised estimates
Akira Build Tracker app

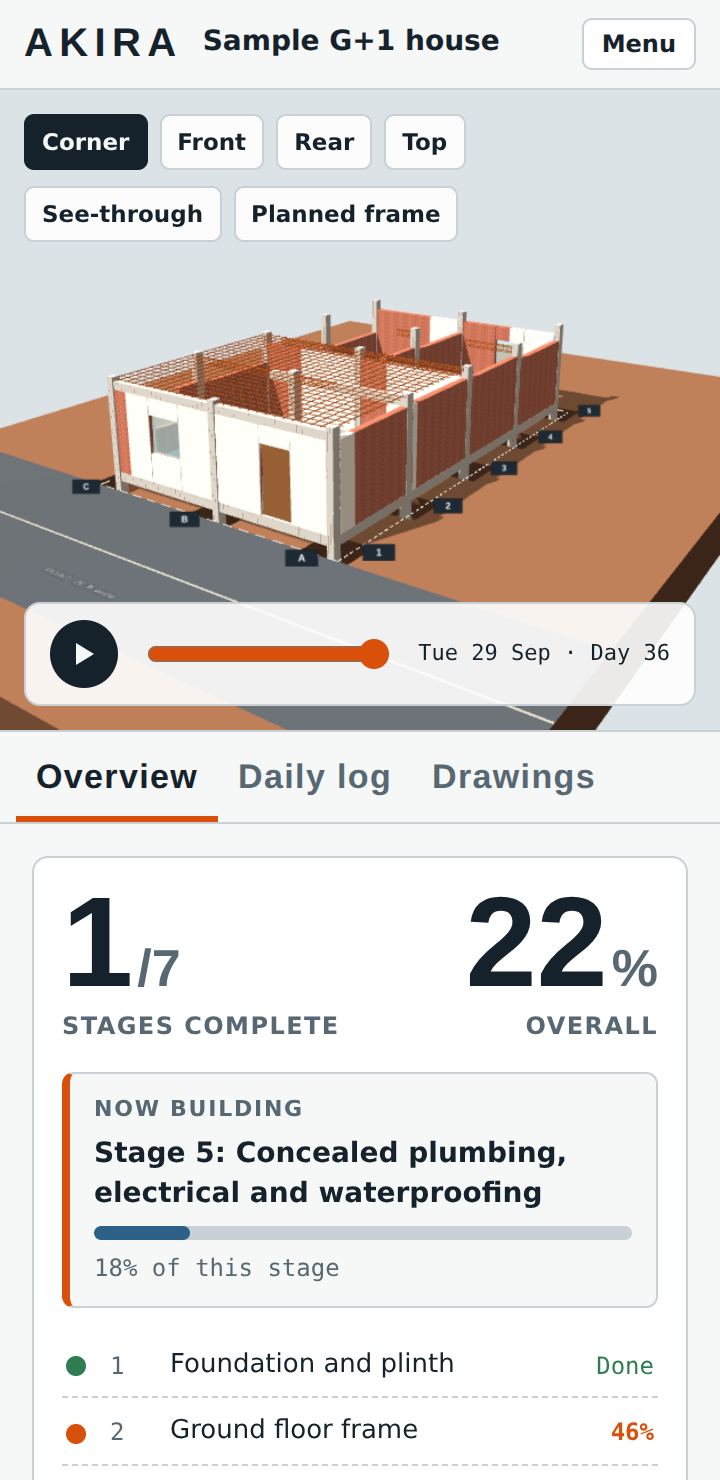

Watch your house grow, day by day

Every family who builds with Akira gets a login to our app. It works on any phone and on a laptop.

  • A 3D model of your house that grows with each day's work
  • Which stage is done, and how far the current one has got
  • Daily site notes and photos
  • Your drawings, in one place
The Akira app showing a 3D model of a house under construction, 1 of 7 stages complete, 22% overall
Services

What Akira builds

Residential work in and around Kovilpatti, sized for one engineer who is on site himself.

G · G+1 · G+2

Turnkey house construction

From foundation to painting, one contract and one person responsible. Materials, labour and supervision included.

See every step →
RCC · IS 456

Structural design

Footing, column, beam and slab design with bar bending schedules, sized for your soil and your loads.

See every step →
BOQ

Estimates and BOQ

Item-by-item bill of quantities you can use for a bank loan, for comparing quotes, or to build yourself.

See every step →
Municipality · Panchayat

Plans for approval

Floor plans, elevations and the drawing set needed for building permission, with guidance on the paperwork.

See every step →
+ 1 floor

Extensions and renovation

Adding a floor, a room or a staircase to an existing house, after checking that the old structure can take it.

See every step →
Labour + supervision

Labour contract with supervision

You buy the materials, Akira brings the crew and the engineering checks. Good for families who want control of purchases.

See every step →
Step by step

How each service works, from first step to handover

Pick a service to see every step in order: what happens, what you do, how long it takes and, for a new house, when each payment falls due.

I build your whole G (ground floor only), G+1 or G+2 house, materials and labour included, and hand you the keys.

Total time
G+1: 8 to 11 months on site, after 7 to 15 weeks of planning and approval
What you have at the end
Your finished, cleaned house and keys, drawings of pipe and wire routes, warranty cards for fittings, and 12 months of free repairs.

Payment percentages shown are for a G+1 house. For G or G+2, your agreement shows the exact split.

  1. First message and free site visit

    1 to 3 daysFree

    Send a WhatsApp message with your plot location and rough idea. I visit your plot for free, listen to your needs and budget, and answer your questions honestly.

    Your part: Share the plot location, size and budget. Show any documents or plans you have. No charge, no obligation.

  2. Plot, soil and documents check

    2 to 5 daysFree. A lab soil test, if needed, is extra

    I measure the plot and dig a test pit. Many plots here have black cotton soil, which swells when wet and shrinks when dry. I set the foundation and fill to suit.

    Your part: Show me the boundary stones, sale deed, patta and EC (encumbrance certificate). I check the plot can get approval before you pay.

  3. House plan with Vastu notes

    2 to 3 weeksPlan fee quoted in writing, deducted from the price if you build with me

    I draw the floor plan around your family, plot and budget, with basic Vastu points for the entrance, kitchen and pooja room. We revise it together until you approve it.

    Your part: List the rooms you need. Adding a floor later? Say so now. Already have a plan? I review it free.

  4. Itemised estimate

    1 to 2 weeksFree

    I write an estimate listing each item's quantity, brand and rate. It says clearly whether GST, septic tank, overhead tank, borewell and power and water connection deposits are included.

    Your part: Compare it with other quotes line by line. Not included: land, approval fees, compound wall, sump (underground water tank), interiors.

  5. Written agreement and booking

    1 to 2 days5% booking advance, part of the total price

    The agreement lists drawings, brands, stage payments, timeline, who pays for water and power during building, and how steel or cement price rises are handled. Your changes are priced in writing first.

    Your part: Read every page. Pay the 5% advance by bank or UPI; the agreement says what is refunded if approval is refused.

  6. Building approval

    3 to 8 weeks, depends on the local body

    I prepare the drawing set. It is signed by a registered engineer, as the rules require, and filed online with your local body (corporation, municipality or panchayat). Work starts only after approval.

    Your part: Give me any documents still needed for filing. Pay the government fees directly; they are not in my price.

  7. Structural design

    2 to 3 weeks, during the approval waitIncluded in the price

    While approval is in progress, I design the frame (foundations, columns, beams, slabs) to IS 456, the Indian concrete standard, with a steel cutting list. I recheck the estimate's steel against it.

    Your part: You get a plain summary of the sizes and steel used, so you know what you are paying for.

  8. Marking the house and digging

    1 to 2 weeks

    I mark the house outline and every column position on the ground with string and lime, check them twice against the plan, then dig the foundation pits to the designed depth.

    Your part: Choose an auspicious day for the bhoomi pooja (ground-breaking prayer). Check the marking with me so the house sits where you expect.

  9. Foundation and footings

    2 to 3 weeks10%, after footings are done

    Termite treatment starts in the pits. A thin layer of plain concrete levels each pit. I cast the footings (column bases) and keep them wet (curing) for 10 to 14 days.

    Your part: Check the steel photos I send before each pour (when concrete goes in). I check bar sizes and spacing against the drawings.

  10. Plinth beam and damp-proof layer

    2 weeks

    Columns rise to the plinth (the raised base the walls sit on) and are tied together by a plinth beam. A damp-proof layer on top stops ground moisture rising into walls.

    Your part: Walk the plinth to see room sizes. Walls are now fixed on the plinth beams, but doors and windows can still shift.

  11. Filling, termite treatment and floor base

    1 to 2 weeks8%, after the plinth and floor base are done

    The inside is filled with sand or gravel soil, never black cotton soil, pressed down layer by layer. I treat it against termites, lay under-floor pipes, then cast a concrete floor base.

    Your part: Check the fill material when it arrives: sand or red gravel soil is right, sticky black soil is not.

  12. Ground floor columns and roof slab

    5 to 6 weeks14%, after the ground floor roof slab is cast

    Columns use ISI-marked Fe500 steel and M20 concrete (standard strength grades), or stronger where the code requires. Beams and slab stay wet for 14 days; props (supports) remain 14 to 21 days.

    Your part: Before pouring, confirm where ceiling lights and fans go; their pipes are laid inside the slab. Watch the pour if you can.

  13. First floor columns and roof slab

    5 to 6 weeks14%, after the first floor roof slab is cast

    The same process repeats for the first floor, including the staircase and the small room over it on the terrace. A G+2 house repeats it once more; a ground-floor house skips it.

    Your part: Payment shares and times here are for a G+1 house. For G or G+2, the agreement shows the exact split.

  14. Brickwork, lintels and door frames

    5 to 6 weeks10%, after the walls are built

    Walls are built with the brick type named in your estimate. Lintels (small concrete beams over doors and windows) and sunshades are cast, and door frames are fixed as walls rise.

    Your part: If your family holds the nilai vaasal ceremony for the main door frame, choose the day. Confirm window sizes and positions early.

  15. Wiring and plumbing lines

    1 to 2 weeks

    Before plastering, wiring pipes and switch boxes go into grooves in brick walls, never in columns or beams. Water and drain pipes are laid; I test water pipes under pressure for leaks.

    Your part: Mark every switch, socket, wall light, AC and tap point with me. Moving one after plastering means breaking the wall.

  16. Plastering and terrace waterproofing

    4 to 6 weeks10%, after plastering is done

    Walls and ceilings are plastered inside and out, then kept wet for 7 days. The terrace gets a slope and a waterproof layer so rain drains fast and does not seep in.

    Your part: Tap walls and listen for hollow sounds; look for cracks or uneven corners. Tell me and I will fix them before painting.

  17. Bathroom waterproofing, flooring and tiling

    4 to 5 weeks10%, after tiling is done

    Bathroom floors are waterproofed, then filled with water for a day to check for leaks. Floors and bathroom walls are tiled, and I check each floor slopes towards its drain.

    Your part: Choose tiles up to the rate per sq ft in your estimate. Costlier tiles? You pay only the difference, agreed in writing.

  18. Doors, windows, painting and fittings

    4 to 6 weeks14%, after painting and fittings

    Doors and windows go in. Inside walls get putty (smoothing paste), primer (base coat) and two coats of paint; outside walls get weatherproof paint. Fittings are then installed and every point tested.

    Your part: Pick paint colours. Check that fitting brands match the written estimate before they are fixed.

  19. Final check and key handover

    1 to 2 weeks5%, after every snag is fixed

    We walk every room together and list small defects (a snag list). I fix each one, clean the house, and hand over keys, drawings showing pipe and wire routes, and warranty cards.

    Your part: Try every door, tap and switch yourself. Pay the final 5% only when the snag list is cleared. Then plan your housewarming.

  20. Free repairs for a year

    12 months after handover

    For 12 months, I repair at no cost any leak, crack or fitting fault from my work. Misuse and changes by others are not covered. I check the terrace before the rains.

    Your part: Send photos of problems on WhatsApp. Hairline cracks where brick meets concrete are common in the first year; I seal those too.

Free help

Useful before you spend a rupee

Ask for any of these on WhatsApp. They are free whether or not you build with Akira.

Free

Site visit and rough quote

I come to your plot, look at access, levels and neighbouring buildings, and give you a realistic budget range.

Ask on WhatsApp →
Free

Second opinion on your plan

Already have a plan from an architect? Send it. I check whether it is structurally sound and buildable at a sensible cost, and I note basic Vastu points.

Ask on WhatsApp →
Free

Soil and foundation guidance

Do you need a soil test? How deep should the footing go? A quick visit answers this before digging starts.

Ask on WhatsApp →
Free

Checklist: 10 things to check before you build

Documents, approvals, water, soil, budget buffer and more, in one page. Sent to your WhatsApp.

Get the checklist →
Cost estimator

What will my house cost?

A rough turnkey figure in seconds, using current rates for our area. The final number comes after a free site visit and your plan.

A 30 × 40 ft plot usually allows about 900 to 1,000 sq ft per floor.
Floors
Finish level
See what each package includes →
Rough turnkey cost ₹—
Total built-up area—
Rate used—
Typical build time—

Includes materials, labour and supervision. Excludes land, approval fees, compound wall, sump and interiors. Estimate only, not a quote.

Send this to Akira for a detailed quote
Packages

Basic, Standard or Premium: what you get

All three packages get the same engineer, the same structural design to Indian standards, concrete strength suited to your site and ISI-marked steel, so every one is safe. Standard and Premium add some extra strength (tougher steel, more factory-mixed concrete). The rest of the difference is finishes, fittings and price limits. Rates are per sq ft of built-up area, turnkey.

Basic

₹1,850/ sq ft

Families who want to keep the cost down: a strong house now, better finishes later

  • Strong frame: M20 and M25 concrete, ISI-marked Fe500 steel
  • Vitrified floor tiles, tile price up to ₹50/sq ft
  • Fly-ash brick walls, steel windows, flat factory-made doors
  • Weekly WhatsApp photos, 6 months of free repairs

About ₹37 lakh for a 2,000 sq ft built-up house (ground + first floor, 1,000 sq ft each), before the extras listed as not included

Ask about this package
Recommended

Standard

₹2,150/ sq ft

Most families: better tiles, doors, windows and bathroom fittings you use every day, plus tougher steel

  • Tougher Fe500D steel, ready-mix concrete for slabs and beams
  • Teak main door, UPVC (rust-free) windows with mosquito mesh
  • Vitrified floor tiles, tile price up to ₹80/sq ft
  • Photos every 2 to 3 days, 12-month free repairs

About ₹43 lakh for a 2,000 sq ft built-up house (ground + first floor, 1,000 sq ft each), before the extras listed as not included

Ask about this package

Premium

₹2,600/ sq ft

Families who want taller, cooler rooms and better finishes that last

  • M25 concrete throughout, ready-mix for footings, slabs, beams
  • Granite or large tiles, price up to ₹140/sq ft
  • Carved teak main door, false ceiling in the hall
  • At least 4 site visits weekly, 18-month free repairs

About ₹52 lakh for a 2,000 sq ft built-up house (ground + first floor, 1,000 sq ft each), before the extras listed as not included

Ask about this package
ItemBasicStandardPremium
Design and structure
Plans and drawings2D floor plans, front elevation (drawing of the front view), structural, electrical and plumbing drawings, and the drawing set for building approval (approval fees extra)Everything in Basic, plus a 3D view of the front of the houseEverything in Standard, plus 2 front design options and a furniture layout
Concrete and cementM20 minimum (the lowest strength IS 456 allows for steel-reinforced concrete) for inside parts kept dry; M25 for footings (the base under each column), roof slab and outside beams and columns, which face soil and rain, made with ready-mix or a lab-designed mix. PPC cement (blended cement, good for durability), e.g. Ramco or equal (another brand of the same quality, agreed with you)Same grades as Basic; slabs and the beams cast with them poured with ready-mix concrete (RMC, mixed in a plant and brought by truck); site-mixed parts with OPC 53 (a faster-setting cement) or PPC, as the mix design needs; PPC for plasterM25 for the whole frame, inside parts too: ready-mix (RMC) for footings, slabs and beams; columns with ready-mix or a lab-designed M25 mix, cement and aggregates weighed on site; cube test for every pour; PPC for plaster
Steel barsISI-marked Fe500 TMT bars (the ribbed steel rods inside the concrete) from a trusted Tamil Nadu maker, named in your estimateISI-marked Fe500D TMT bars (bend more before breaking), e.g. TATA Tiscon or equalSame as Standard: Fe500D, e.g. TATA Tiscon or JSW Neosteel or equal
Ceiling height10 ft from one floor level to the next (about 9.5 ft from your floor to the ceiling)Same as Basic: 10 ft floor to floor, about 9.5 ft to the ceiling10.5 ft floor to floor (about 10 ft to the ceiling), for a cooler, airier room
Walls and roof
WallsFly-ash bricks (factory-made, even size); 9-inch outer walls, 4.5-inch inner wallsFly-ash or red chamber bricks (kiln-fired clay), your choice; same wall thicknessWire-cut red bricks (machine-made, even size, strong); same wall thickness
Terrace waterproofingWaterproof additive in the roof concrete; cement layer sloped to the drain pipesEverything in Basic, plus 2 coats of flexible waterproof coating, e.g. Dr. Fixit or equalEverything in Standard, plus a heat-reflective white top coat that keeps the top floor cooler
Bathroom waterproofingCement-based waterproof coat on the floor, 1 ft up the walls and 6 ft up the shower wall; floor kept filled with water for 24 hours to check for leaks before tilingFlexible polymer coat (stretches, so hairline cracks do not leak) on the floor, 1 ft up the walls and 6 ft up the shower wall; same 24-hour water test before tilingSame as Standard, plus epoxy grout (a tile joint filler that does not soak up water) in the shower area
Flooring and tiles
Floors and staircaseVitrified tiles (hard, glossy tiles), 2x2 ft, tile price up to ₹50/sq ft; granite steps up to ₹80/sq ftVitrified tiles, 2x2 or 2x4 ft, tile price up to ₹80/sq ft; granite steps up to ₹110/sq ftGranite or large tiles (fewer joints), price up to ₹140/sq ft; granite steps up to ₹150/sq ft
Bathroom and kitchen tilesNon-slip bathroom floor tiles; bathroom walls tiled to 7 ft; a 2 ft tiled strip above the kitchen counter; tile price up to ₹45/sq ftNon-slip bathroom floor tiles; bathroom walls to 8 ft; 2 ft tiled strip above the kitchen counter; tile price up to ₹60/sq ftNon-slip bathroom floor tiles; bathroom walls to the ceiling; full wall above the kitchen counter; tile price up to ₹80/sq ft
Kitchen and bathrooms
Kitchen counter and sinkGranite top (local colour) up to ₹120/sq ft on a concrete shelf; single-bowl steel sinkGranite top up to ₹160/sq ft; steel sink with drying area, e.g. Nirali or equalGranite top up to ₹220/sq ft; double-bowl steel sink, e.g. Nirali or equal
Toilet, basin and tapsWestern or Indian toilet, wash basin, chrome-plated taps and shower; basic range, e.g. Cera or equalWestern toilet with soft-close seat (Indian on request), wash basin, wall mixer (one tap for hot and cold) with shower; mid range, e.g. Parryware or equalWall-hung toilet with hidden tank (easy to clean under), wash basin, wall mixer with overhead shower; top range, e.g. Jaquar or equal
Bathroom fittings price limit (toilet, basin, taps, shower)Up to ₹18,000 per bathroomUp to ₹30,000 per bathroomUp to ₹60,000 per bathroom
Doors and windows
Main doorCountry wood (vengai) frame; flush door (flat, factory-made), 35 mm thick, waterproof grade (BWP), with laminate finishTeak frame and teak panel door; up to ₹55,000 for door and frameTeak frame and carved teak door with stainless steel handle, hinges and lock; up to ₹85,000 for door and frame
Inside doorsCountry wood frames, 30 mm flush doors with enamel paint; PVC doors in bathroomsCountry wood frames, 32 mm flush doors with laminate; WPC (wood-plastic, does not rot) doors in bathroomsCountry wood frames, 32 mm flush doors with veneer (thin real-wood sheet) or laminate; WPC doors in bathrooms
WindowsPainted steel frame windows with clear glass (mosquito mesh can be added at extra cost)UPVC sliding windows (strong plastic frames: no rust, no termites) with mosquito mesh; up to ₹600 per sq ft of windowBranded UPVC with mosquito mesh, e.g. Fenesta or equal, up to ₹1,000 per sq ft of window; teak windows if you prefer, and you pay the difference
Grills and stair railingPlain mild steel (MS) grills; MS stair railing, enamel paintedMS grills in a simple pattern; stainless steel railing (grade 304, does not rust)MS grills in your chosen design; stainless steel 304 railing with teak handrail
Electrical and plumbing
Wiring and switchesISI FR copper wire (slow to catch fire), e.g. V-Guard or equal; modular switches, e.g. Anchor Roma or equalFRLS copper wire (less smoke in a fire), e.g. Finolex or equal; modular switches, e.g. Legrand or equalFRLS copper wire, e.g. Polycab or Havells or equal; top-range modular switches, e.g. Legrand Arteor or equal
Electrical pointsAbout 40 per 1,000 sq ft (a point is one light, fan or socket); AC point in 1 bedroom per floorAbout 50 per 1,000 sq ft; AC point in every bedroom; wiring for a home inverter (power backup for lights and fans)About 65 per 1,000 sq ft; AC points in every bedroom and the hall; inverter wiring
Water and drain pipesCPVC pipes (made for hot water) for hot lines, UPVC (plastic) for cold; ISI-marked PVC drain pipesCPVC for hot and cold water, e.g. Ashirvad or equal; ISI PVC drain pipesCPVC hot and cold, e.g. Astral or equal; ISI PVC drain pipes; pipes ready for a solar water heater
Overhead tankSized for your family, at least 1,000 litres; 3-layer plastic tank, e.g. Sintex or equalSized for your family, at least 1,500 litres; 3-layer plastic tankSized for your family, at least 2,000 litres; 4-layer insulated tank (keeps water cooler)
Painting and finishing
Inside walls1 coat putty (smooths the wall), primer (base coat), 2 coats emulsion (water-based wall paint), e.g. Asian Paints Tractor or equal2 coats putty, primer, 2 coats emulsion, e.g. Asian Paints Apcolite Premium or equal2 coats putty, primer, 2 coats washable emulsion, e.g. Asian Paints Royale or equal
Outside wallsPrimer and 2 coats exterior paint, e.g. Asian Paints Ace or equalPrimer and 2 coats weather-proof paint, e.g. Asian Paints Apex or equalPrimer and 2 coats of long-life weather-proof paint, e.g. Asian Paints Apex Ultima or equal; texture finish (a raised pattern) on the front wall
False ceilingNot included (can be added at extra cost)Not included (can be added at extra cost)Gypsum false ceiling (a lowered ceiling with built-in lights) in the hall, lights included
Service
My site visitsAt least 2 visits a week, and I am there at every key stage: footings, columns and each slab. No concrete is poured until I have checked the steel on siteAt least 3 visits a week; I am there at every key stage and check the steel on site before every pourAt least 4 visits a week; I am there at every key stage and check the steel on site before every pour
WhatsApp photo updatesWeekly photos and a short progress notePhotos every 2 to 3 days, plus a weekly progress noteDaily photos, a weekly progress note and a short video walk-through each week
Free repairs after handover6 months: I fix leaks, cracks and faults from my work free of cost; product faults go through the maker's warranty and I help you claim. Structural faults from my design or work stay my responsibility after this period12 months of the same free repairs and cover, with check visits at 6 and 12 months18 months of the same free repairs and cover, with check visits at 6, 12 and 18 months

Included in every package

  • Structural design to Indian standards (IS 456 for concrete, IS 875 for loads, IS 1893 for earthquakes), with a bar bending schedule (a list of every steel bar)
  • Concrete grade and cover over the steel as IS 456 needs for your site (near the sea, for example in Thoothukudi, that means M30 and thicker cover, priced in your estimate); lab cube tests (concrete samples crushed to prove strength) for every slab; at least 10 days of water curing, 14 in hot weather
  • All materials, labour and my supervision, from anti-termite treatment of the soil to handover, with a handover file of drawings, bills and warranty cards
  • Rainwater harvesting pit, which Tamil Nadu rules require for every new building
  • Main switch board with MCBs (trip switches for overload), an RCCB (cuts power if current leaks, to prevent shocks) and 2 earth pits
  • Written itemised estimate before you sign, showing the amount due at each finished stage and how long the rate is fixed; payments are linked to finished stages, never a large advance

Not included in any package

  • Land, its registration, soil test fee and borewell
  • Government approval fees, and EB (electricity) and water connection deposits
  • Temporary power connection, and the water and electricity used during construction
  • Extra foundation work if my soil check finds black cotton (karisal) soil, rock or filled ground: deeper footings, sand or gravel cushion, under-reamed piles (short piles with a bulb at the base), extra plinth filling
  • Outside works: compound wall and gate, sump (underground water tank) and pump motor, septic tank and soak pit or sewer connection charges
  • Modular kitchen, wardrobes and other interiors; false ceiling, except the hall in Premium
  • Fans, light fittings, geyser, AC units, inverter and solar heater (the wiring and points for them are included)

Price limits are the shop price of each tile, fitting or door, with the labour to fix it included: choose something costlier and you pay the difference plus any extra fixing cost (for example adhesive for large tiles), choose something cheaper and the difference comes off your bill, and you can upgrade single items, such as a Premium main door in a Standard house, without changing package, always agreed in writing before I order. Rates are per sq ft of built-up area (measured over the outer walls of each floor, including sit-out, balconies and the staircase room on the terrace) at 2026 prices, and assume normal firm soil, footings about 5 ft deep, a plinth (the raised base the walls sit on) up to 2 ft high, 1 kitchen per house and up to 2 bathrooms per 1,000 sq ft; anything beyond this is itemised in your written estimate before you sign.

Current project

A G+1 house, going up now

Akira is a new company, so instead of old photos, here is the house we are building today. Updated as each stage is finished.

    Type
    Independent house, G+1
    Location
    Kovilpatti
    Structure
    RCC frame, M20 concrete, Fe500 steel
    Scope
    Turnkey, design to handover
    GKFounder photo goes here
    About the founder

    Hello, I am Gokul.

    I am a civil engineer with a B.E. (Civil) and several years of site experience. I started Akira Construction so that families around Kovilpatti can build with an engineer they can call directly, who is on the site himself, and who shows them every cost in writing.

    Akira is a new company, and I will not pretend otherwise. What I can promise is my own time on your site, honest numbers, and regular photo updates of every stage, like the house you can follow above.

    "Your house gets built once. It should be built right."
    Questions

    What first-time builders ask

    Will the cost go above the estimate?

    The estimate lists every item with quantity and rate. The cost changes only if you change the design or finishes, or if a material price moves sharply, and any change is agreed in writing before work continues.

    How do payments work?

    Payments are linked to finished stages: a 5% booking advance when you sign, then foundation, plinth, each slab, brickwork, plastering and finishing. You pay for work you can see, never a large amount in advance.

    How long does a G+1 house take?

    Usually 8 to 11 months on site for about 2,000 sq ft, after 7 to 15 weeks of planning and approval. Heavy monsoon rain can add a few weeks. You get a stage-wise schedule with the estimate.

    How do I know the concrete and steel are good?

    Only ISI-marked Fe500 or Fe500D steel and branded cement are used. Concrete mix, cover blocks and curing are checked by me on site, and every slab gets a lab cube test.

    Is the structure safe?

    Every house gets a proper structural design for its soil and loads, following IS codes, before work starts. Reinforcement is checked against the drawings before every pour.

    You are a new company. Why should I trust you?

    Fair question. Visit the house we are building now, meet me there, and look at the work yourself. Then decide.

    Which areas do you cover?

    Kovilpatti, Ettayapuram, Kayathar, Thoothukudi, Tirunelveli, Vilathikulam, Sankarankovil, Sattur and nearby villages. Ask on WhatsApp if your town is not listed.

    Contact

    Book a free site visit

    WhatsApp is fastest. Or fill this in and it opens WhatsApp with your details ready to send.

    Kovilpatti, Tamil Nadu
    Open in Google Maps
    Phone
    +91 90000 00000
    Hours
    Mon to Sat, 9 am to 7 pm
    Area
    Kovilpatti, Ettayapuram, Kayathar, Thoothukudi, Tirunelveli, Vilathikulam, Sankarankovil, Sattur
    Follow
    Instagram · YouTube · Facebook
